Drop your plan set. Your drawing sheets are counted in your browser — nothing is uploaded to get a price — and the takeoff lands in 4 days, or 48 hours with Rush. Miss the date and you are refunded in full, unasked.
What you get is a graded first draft, not a certified estimate — every line says whether it was counted, calculated or assumed, so you know what to verify before you bid.
What we count: drawing sheets — any page with a title block, at any size. Full-size, half-size 11×17, A3: a sheet is a sheet. Specifications, schedules, addenda, reports and other document pages are read but never charged. A DWG or DXF adds nothing to the price: when a PDF is included, the PDF is what we price and measure, and the CAD file only verifies dimensions. Your band is set by that sheet count and locked before you pay.
Drag & drop your plan set here, or click to browse
PDF, DWG, DXF — multiple files OK. Your files never leave this device.
You are ordering an automated first-draft takeoff, provided as-is and graded line by line. It is the starting point for your own estimate — not a certified quantity survey, and not a number to bid on unverified.
A takeoff is only as complete as what you send. Missing schedules or trades do not stop the work — they become assumptions, exclusions or reduced-confidence lines in your workbook. We score your submission against this list before you pay:
Your files stay on your device until you have seen your price and chosen to order.
PDF plan set — and the DWG/DXF if you can get it. Your drawing sheets are counted in your browser and the price band comes from that count.
One flat price, shown before you commit and locked at checkout. Only now do your files leave your device, with your order code.
Every quantity traced to a sheet and graded, with the calculation behind it — one ZIP by email, led by a Delivery Note and a README that says what to open first.
Four products, each containing the one before it. Pick your size by drawing sheets — spec pages neither count nor cost. Your exact band comes from your own sheet count, in your browser, before checkout. Prices in USD; US projects only at launch.
Every product is a graded first draft provided as-is — a starting point for your own estimate, not a certified quantity survey and not a bid.
Above 300 drawing sheets, each started block of 50 sheets adds $20 (Overview) / $40 (Workbook) / $50 (Kit) / $60 (Full) — computed from your own sheet count at upload, before you pay. Sets beyond 1,037 total pages, the largest we have actually measured, are declined automatically rather than guessed at. Launch pricing; may be revised for future orders, never for yours.

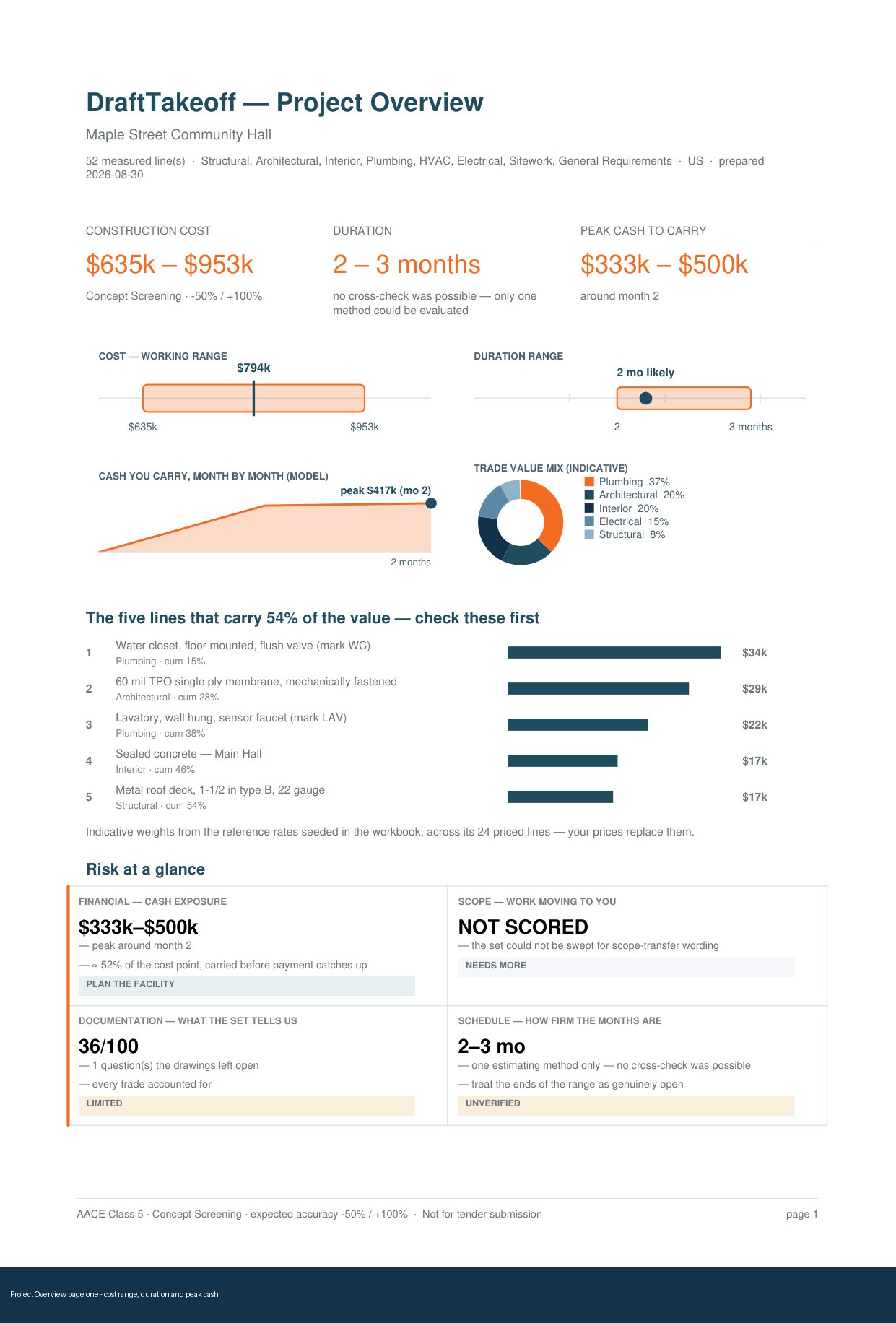

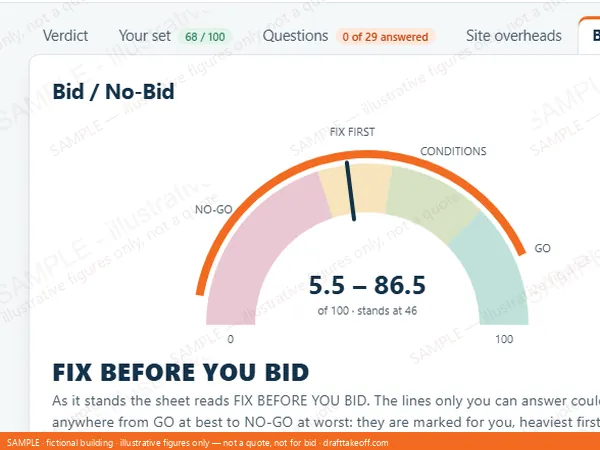

Should you bid this job at all? The Project Overview answers on one page, from your own drawing set — and where a sheet cannot answer, it says so in writing instead of guessing. That last row is the product, not a defect.

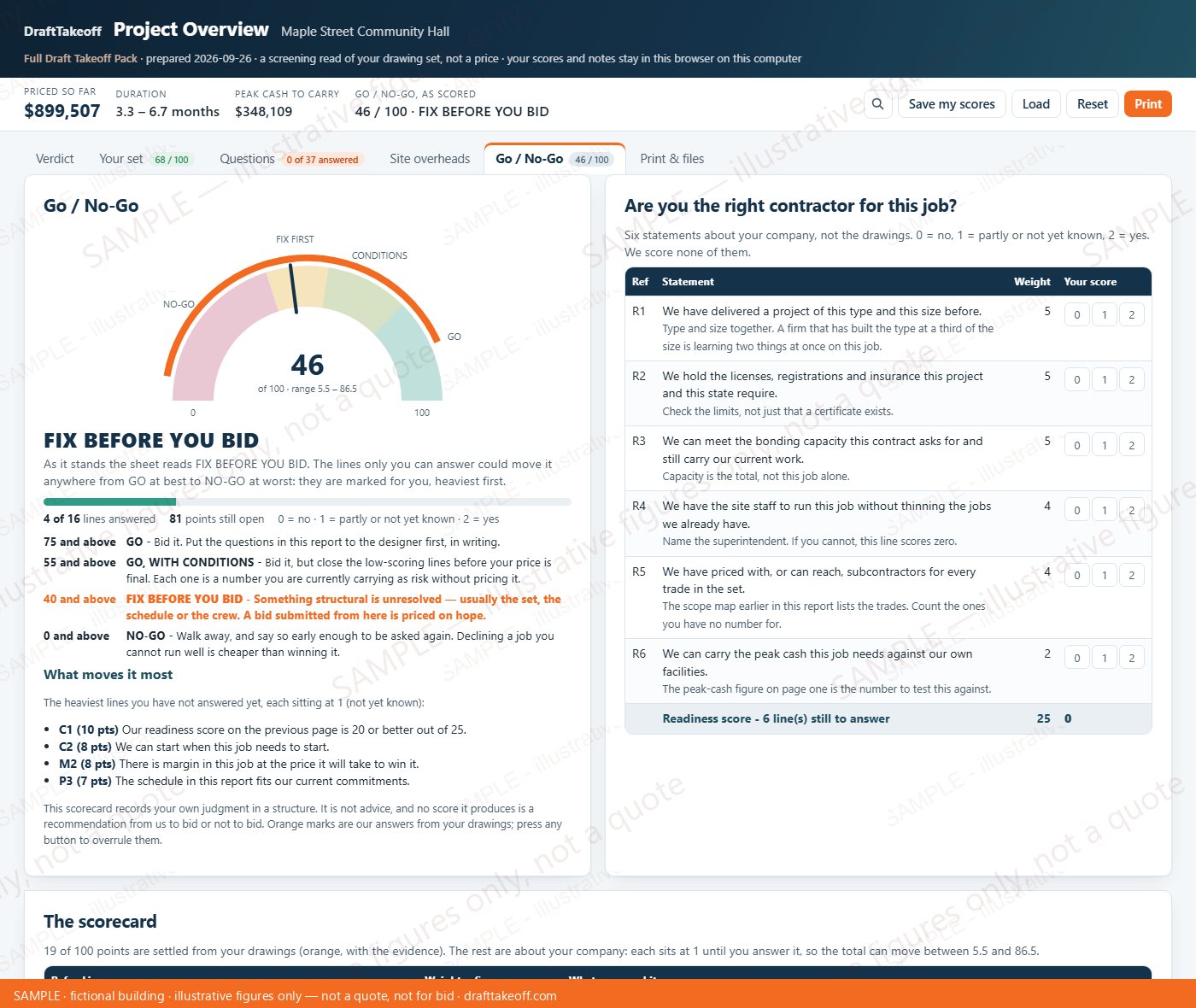

A construction-cost range with its AACE estimate class and its −50% / +100% range printed beside it. A screening number that looks precise is the most dangerous number on a bid table.
A duration range cross-checked three ways. When the contract documents state the period, we quote theirs and say so.
Peak cash and the month it lands — the number that decides whether you can carry the job, not just win it.

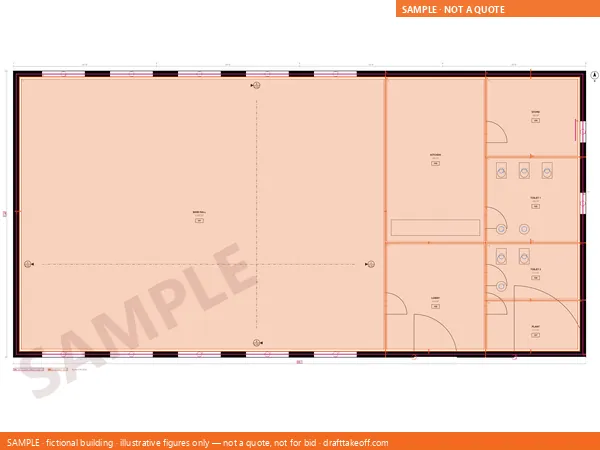

NIC, by-others, by-owner, alternates, deferred submittals — swept out of the set with the sheet each one sits on.

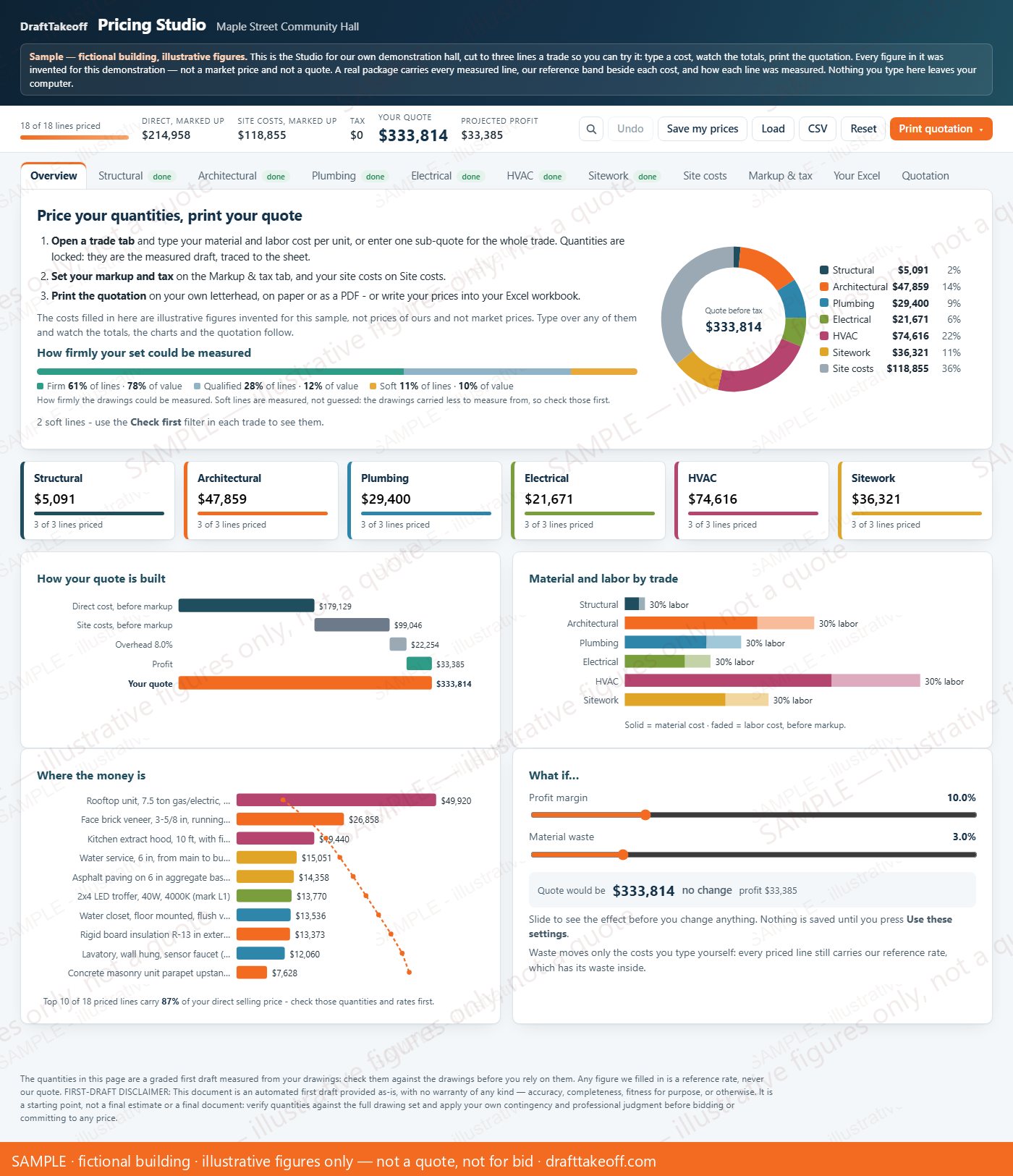

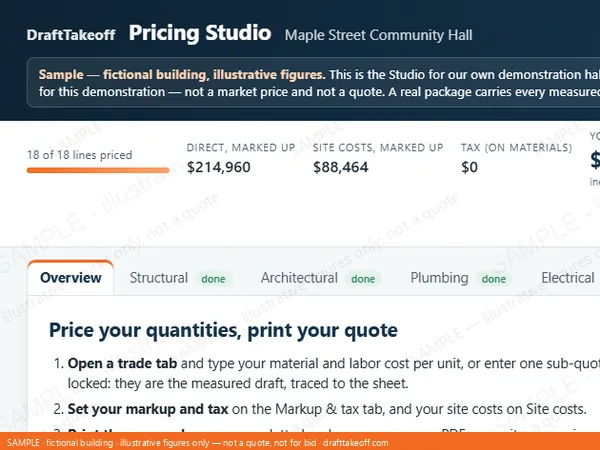

This is a complete package, start to finish — a 3,200 SF community hall run through the same pipeline your job goes through, seven trades, 51 lines. What you cannot see in advance is your own numbers: those are measured from your drawings after checkout. What you can see, in full, is every document you will receive and the standard it is held to. Click any page to read it, or open the files themselves.
The building is ours. We drew this set ourselves — sixteen sheets of a
hall that does not exist — so that every page we show you is ours to give. A client's drawings
are never published, and neither is anyone else's.
Two things differ from what you receive. The workbook here is watermarked and
read-only, and its unit-cost cells are empty: your delivered file arrives with an indicative
rate already in place wherever we hold a published one. Where the drawings could not answer,
lines say SOURCE INSUFFICIENT instead of guessing — you will find that in the sample too.
Nothing to sign up for.
VERIFIED AGAINST THE STANDARDS YOU ALREADY BUILD TO
ACI 117 · ACI 318 · ACI 308.1 · ASTM C94 / C143 / C1064 / C31 · ASTM C39 · AISC 303 · AWS D1.1 —
each cited on the Inspection & Test Plan line it governs
The analyser prices your set in seconds. The same pipeline measures every sheet, grades every quantity and traces each one back to the drawing it came from. Where the drawings cannot answer, it prints SOURCE INSUFFICIENT — never a guess. Its gates can refuse: a package that fails a check is not sent late, it is not sent, and you are refunded.
Exactly what lands in your inbox on a Full Package — one ZIP by email, five numbered folders, a Delivery Note and a README in front. This is the manifest the packager builds, not a marketing list.
The go / no-go answer. The .docx carries the same figures unbranded, for your board pack.
Quantities with a calculation table behind each one, and a reading view that opens offline in any browser. The workbook is the working file where your unit costs go.
The gaps and open decisions in writing — questions for the designer, a scoped request per trade, alternates priced as their own totals.
The same quantities as data, for your own estimating system. No re-typing out of a PDF.
For the job you win: buy-quantities with every factor carrying its source, waste in its own column, and an ITP whose sections exist only for work this project contains.
A printable one-page receipt of what you bought and every file in the package, and a front door that says what opens what.
What we deliberately leave out, and why. A draft contract (a binding agreement drafted by non-lawyers), a schedule (derived from our line count, which is a property of our document rather than of your building), a submittal log (it presumes an approval workflow we do not know), a proposal (you write your own) and a slide deck (its polish would overstate the work). Eight documents in total are named and refused in our own packager rather than quietly missing.
The Full Package keeps going past the quantities, into the four documents a site team needs in week one — all derived from the same measured lines, so nothing is re-entered.

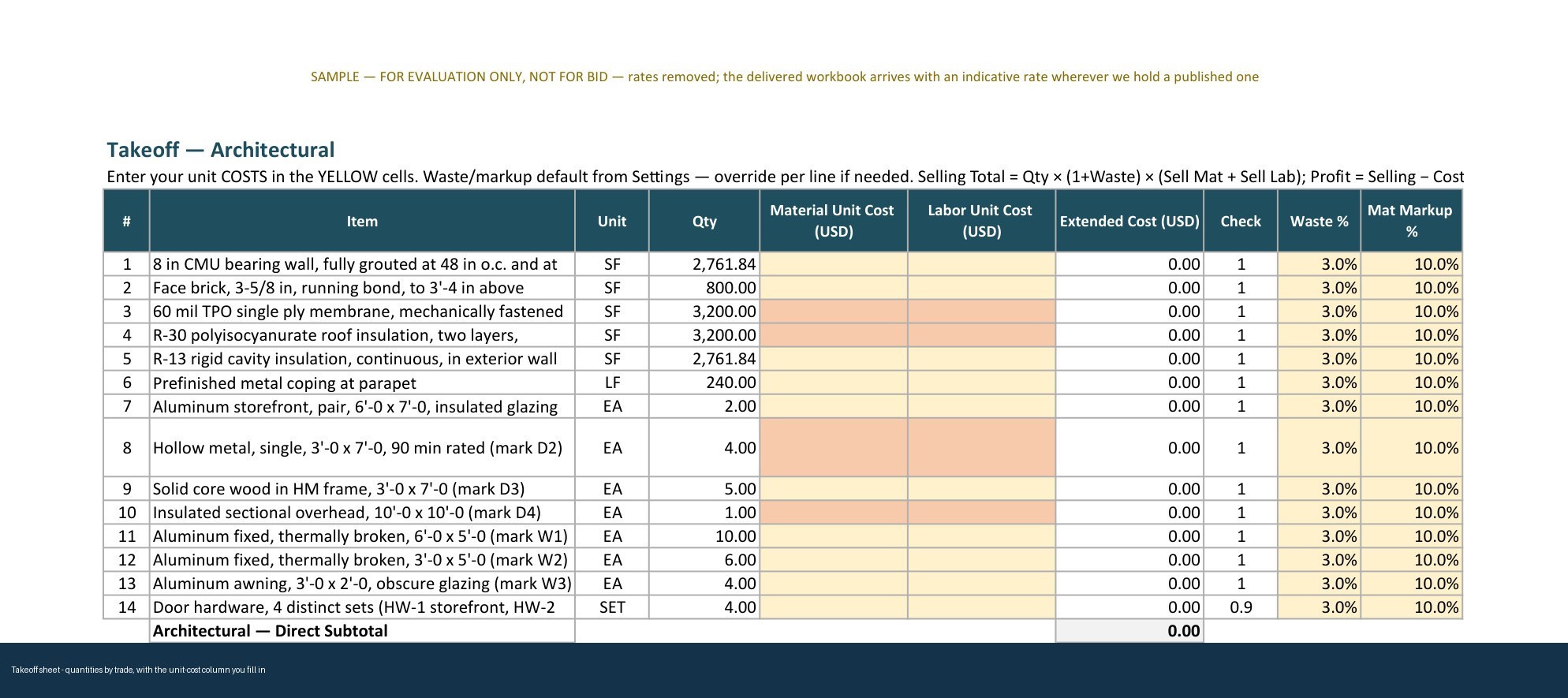

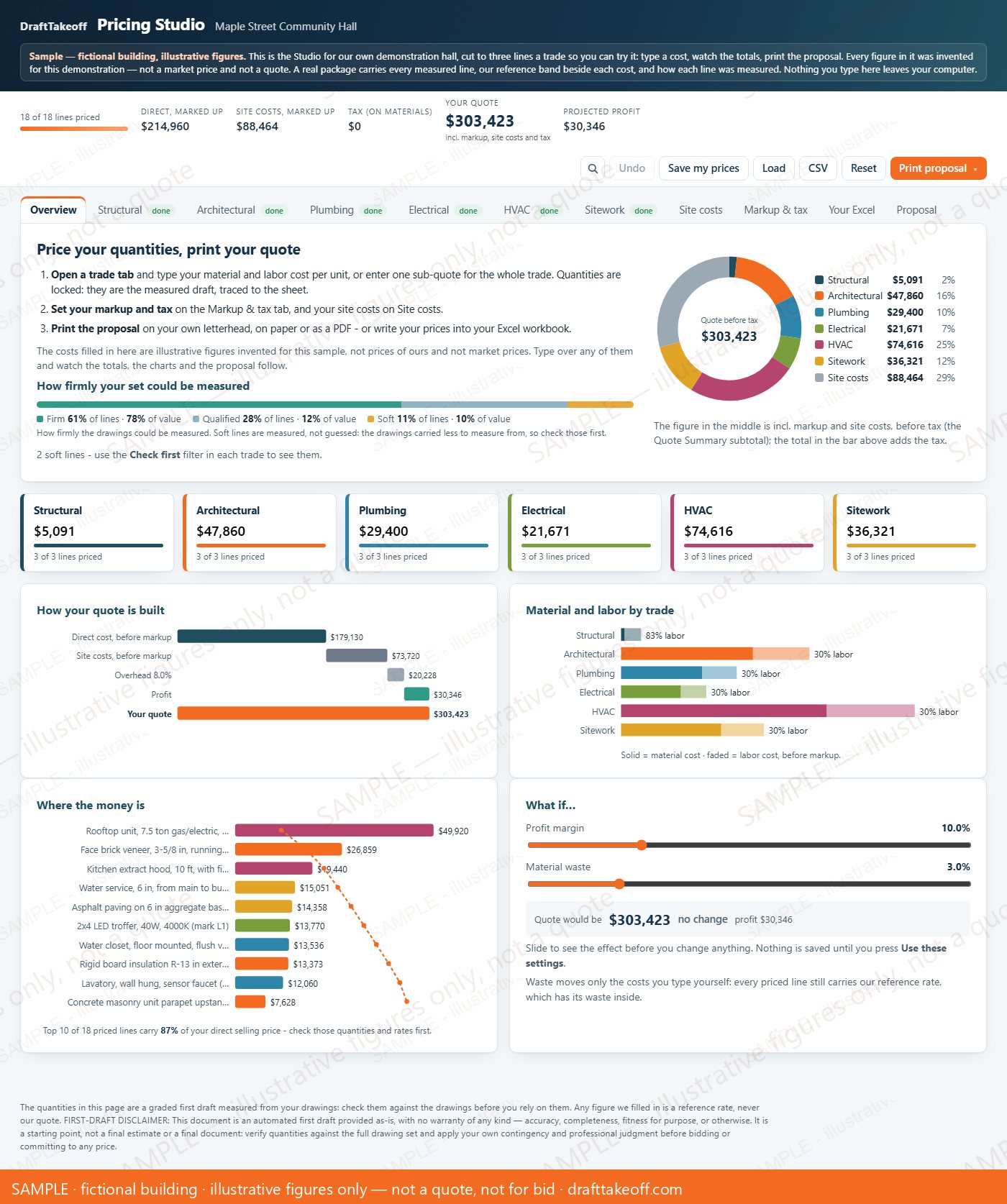

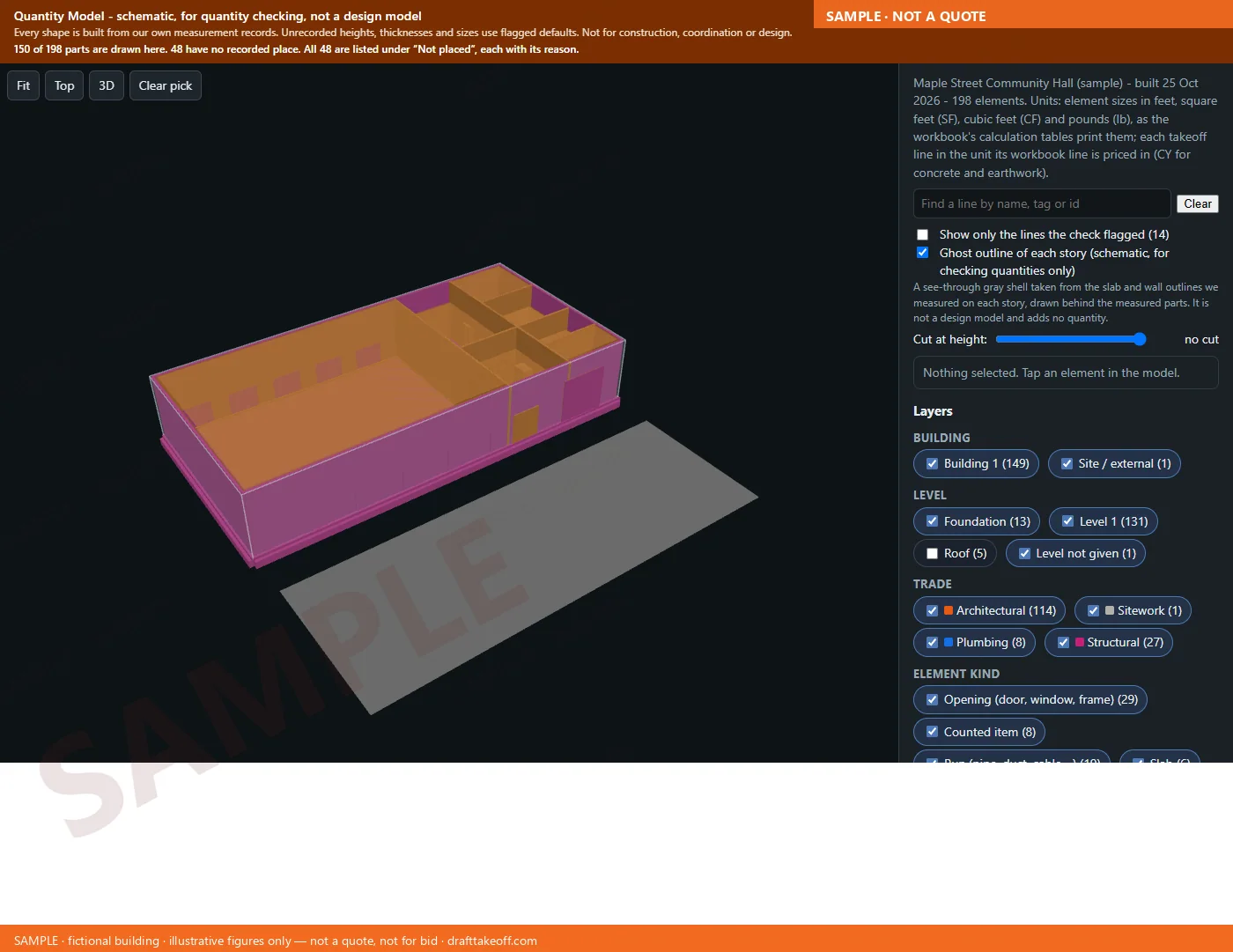

Measured lines broken into what you order — block, mortar, board, paint — with net quantity, sourced waste and order quantity in separate columns. Every factor prints the standard it came from.
Hold and witness points for exactly the divisions your project contains. Standards cited by name; the governing edition stays your contract's, and the document says so on every page.

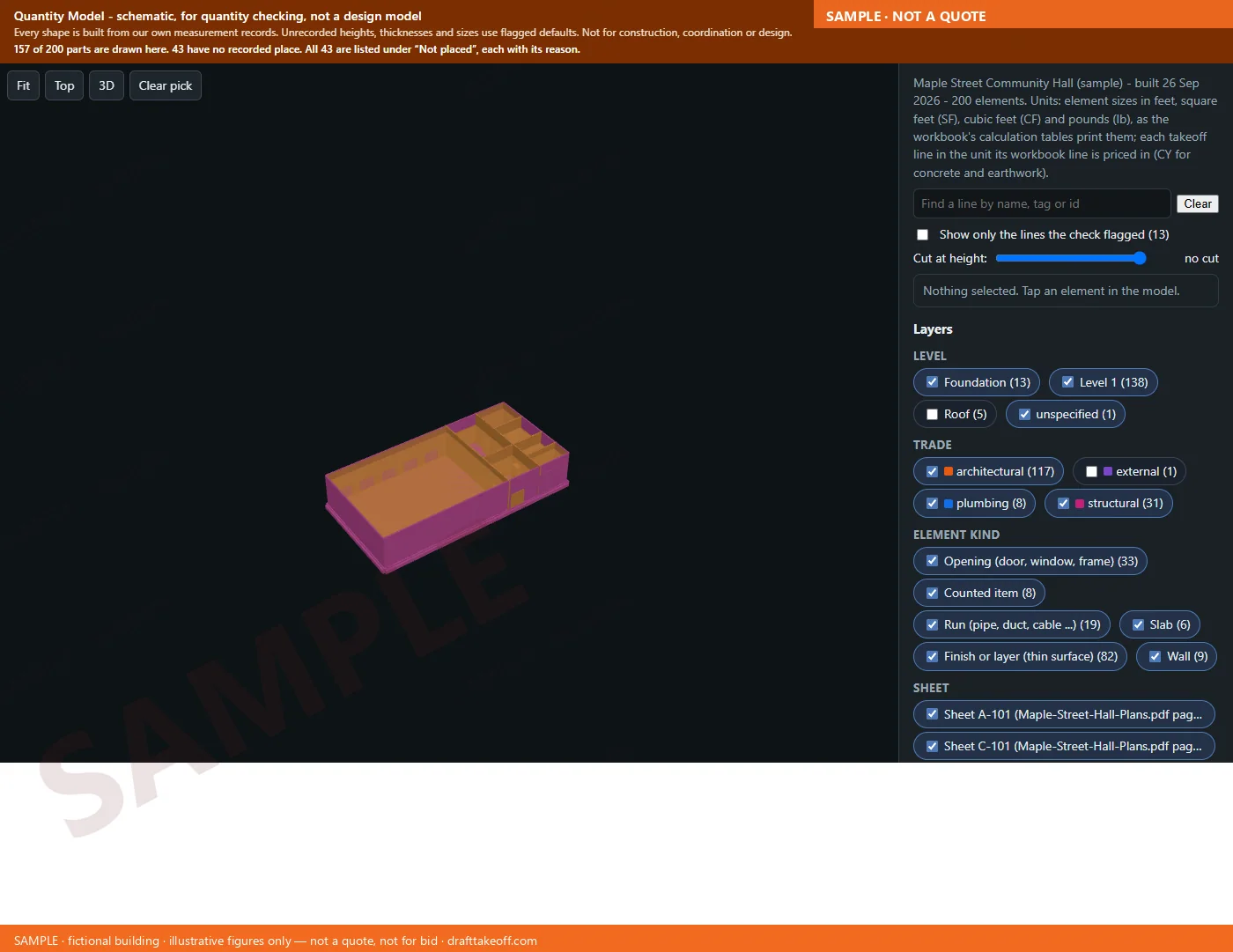

Cut lengths and weights from the takeoff's own bar-level calculations, laps stated. Bend shapes stay with the structural drawings — we do not invent them.
Every opening on one sheet. Hardware set contents stay with the spec section that defines them, referenced rather than restated.

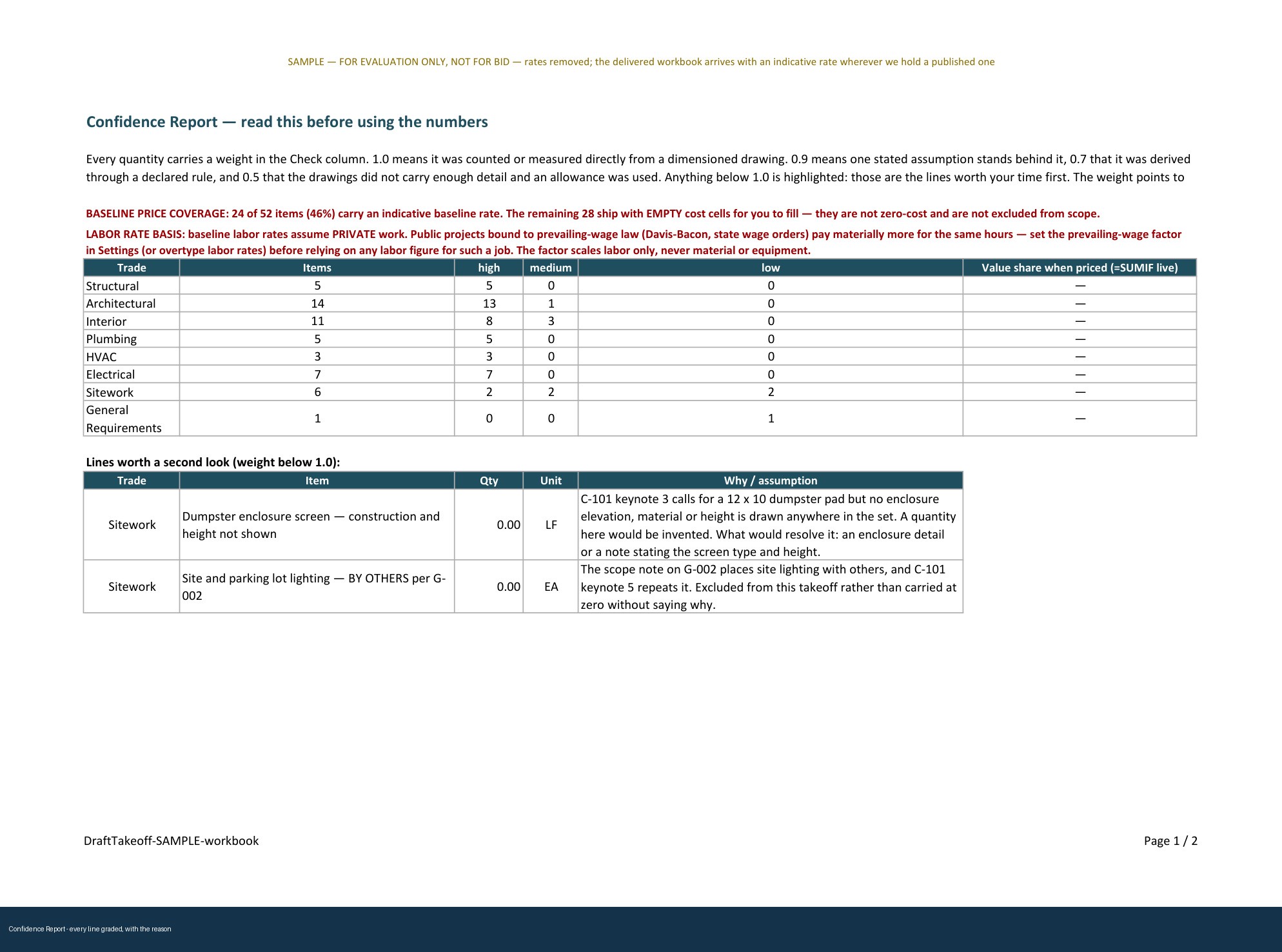

No one working from drawings alone can honestly promise a perfect count — including us. So we publish no accuracy percentage and give no warranty on any quantity. Everything below is a claim about what you can check.

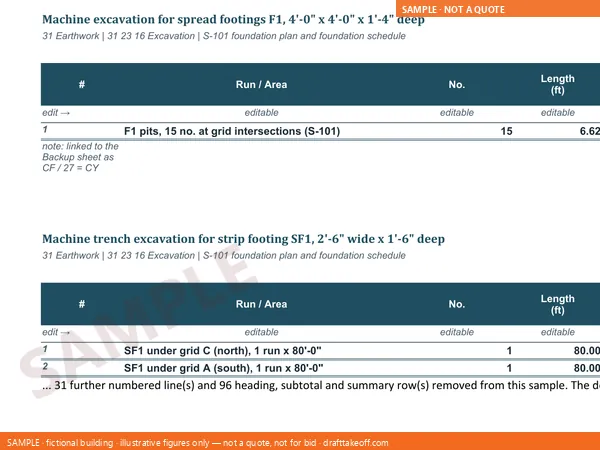

Every quantity sits on a calculation table with the dimensions that produced it. Correct a length and the takeoff, totals and priced columns follow.
Elsewhere: a number in a cell. If it is wrong, you re-do the takeoff.Where the drawings cannot answer, the line says so and the quantity stays zero, with the reason and what would resolve it.
Elsewhere: an allowance that looks measured, discovered on site.High, Medium or Low with the assumption beside it, and a verify-these-first list — so your review time goes where it changes the bid.
Elsewhere: one confidence statement for the whole document.Blind predictions registered publicly ahead of the opening they are measured against, results published either way.
Elsewhere: testimonials.The band comes from your own sheet count, read in your browser, and is locked before you pay.
Elsewhere: "request a quote", then a sales call.The instant quote is computed on your device — open the network tab and watch nothing happen. Files move only when you order.
Elsewhere: an account and an upload before you see anything.Ask and you get the whole amount back. Miss the date and you are refunded without asking.
Elsewhere: a support ticket and a policy to argue with.One flat price per project. The deliverables open in the tools you already have.
